catchment management
THE SEDIMENT PROBLEM
Research and monitoring undertaken by PBPL and partners indicates up to 80% of the sediment depositing in the Port’s navigation channel at the mouth of the Brisbane River originates from degraded creek banks in the Lockyer Valley, around 100km upstream of the Port of Brisbane.
Sediment build up is removed through maintenance dredging (conducted under strict permit conditions) to ensure safe commercial shipping.
THE APPROACH
the benefits
Projects typically clear and stabilise degraded, weed-infested creek banks that are prone to erosion, then revegetate sites with native plants to further stabilise banks and help prevent soil entering the waterway.
While each project site is unique, benefits include:
-
reduced sediment loss and erosion
-
native creek vegetation increases and provides habitat for land and aquatic life
-
improved flora, fauna and in-stream habitats
-
improved water quality both within the creek and within the broader catchment
-
improved land security for producers when these creeks adjoin agricultural land.
OUR PROJECTS

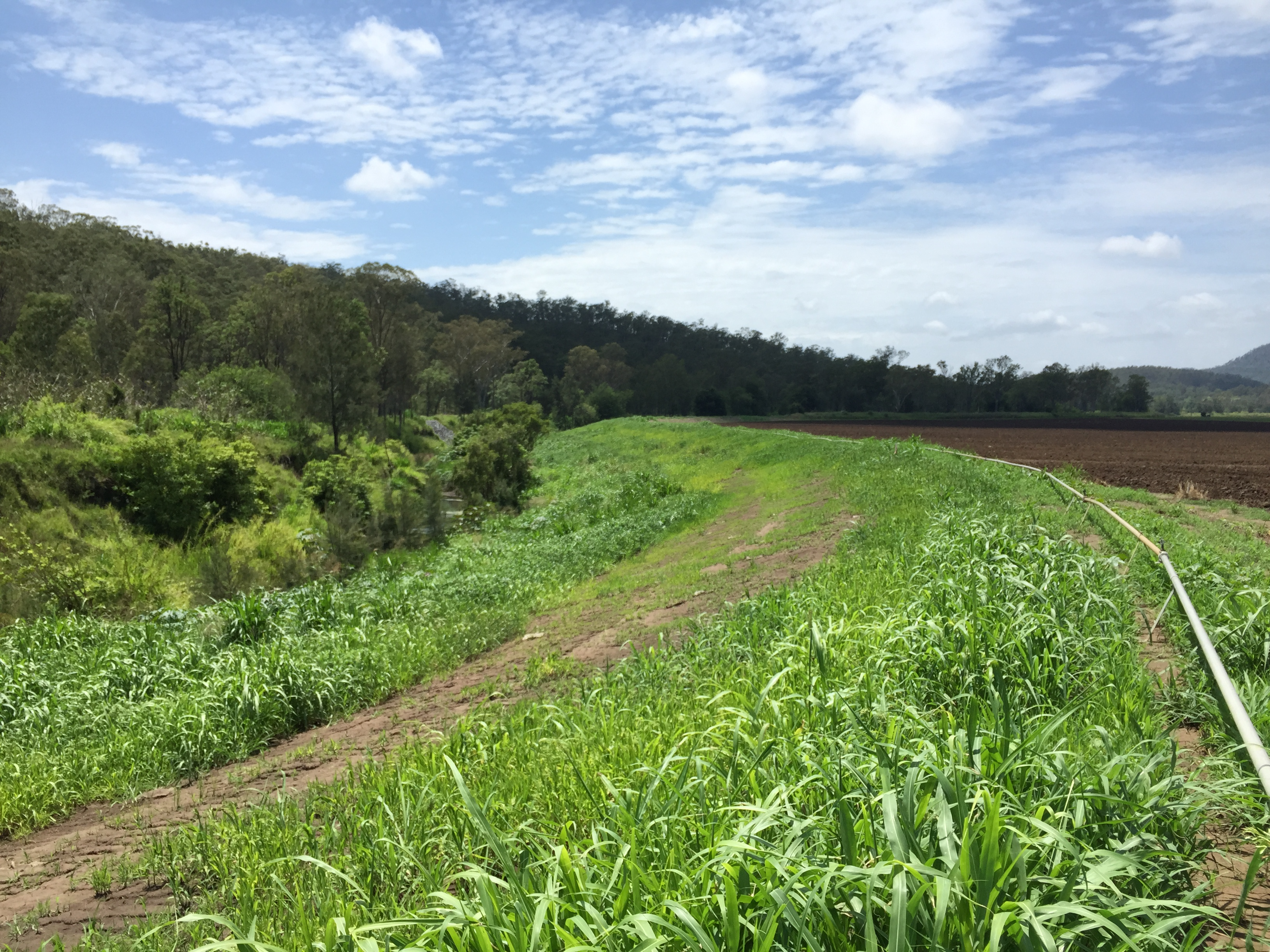

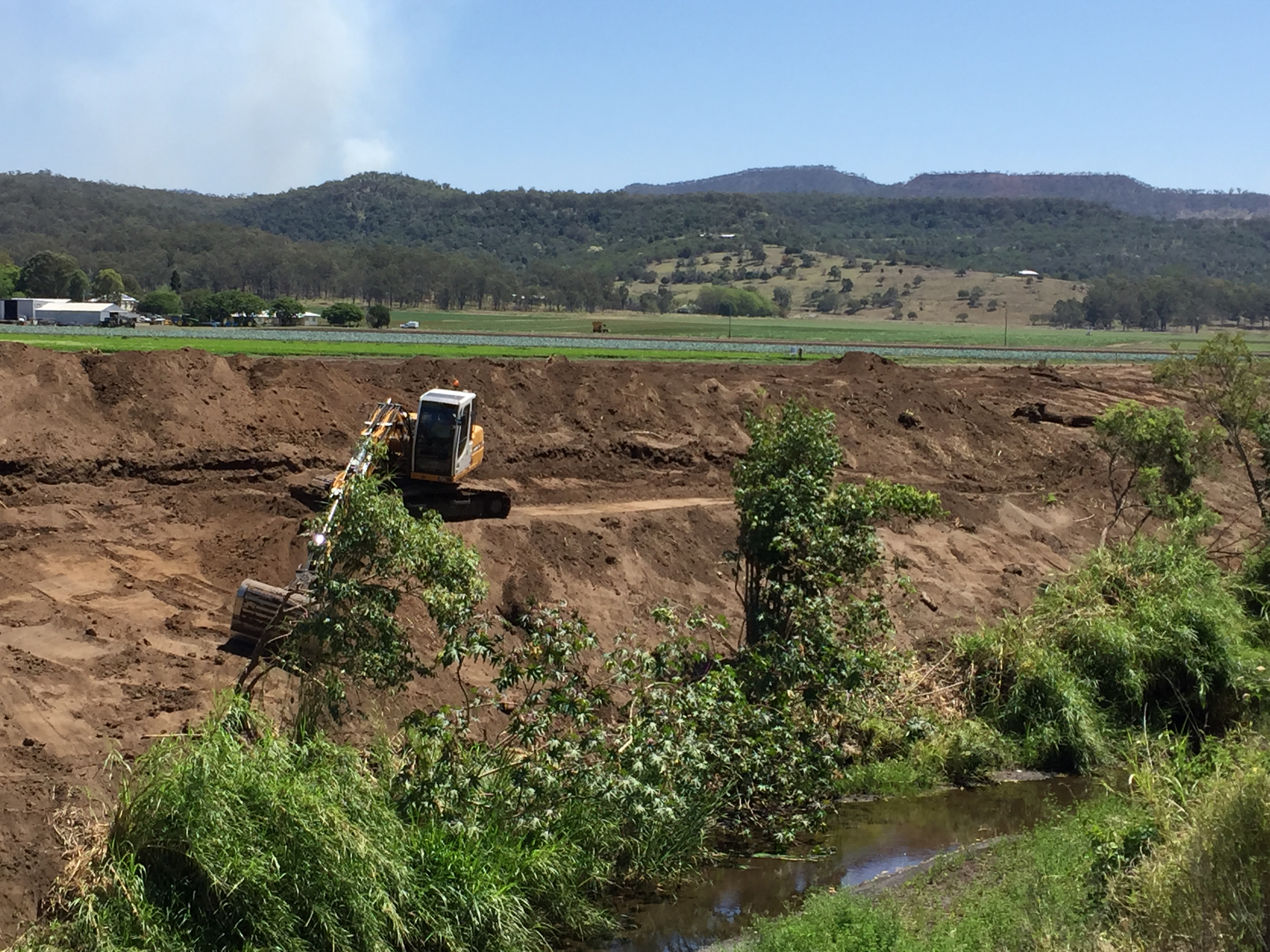

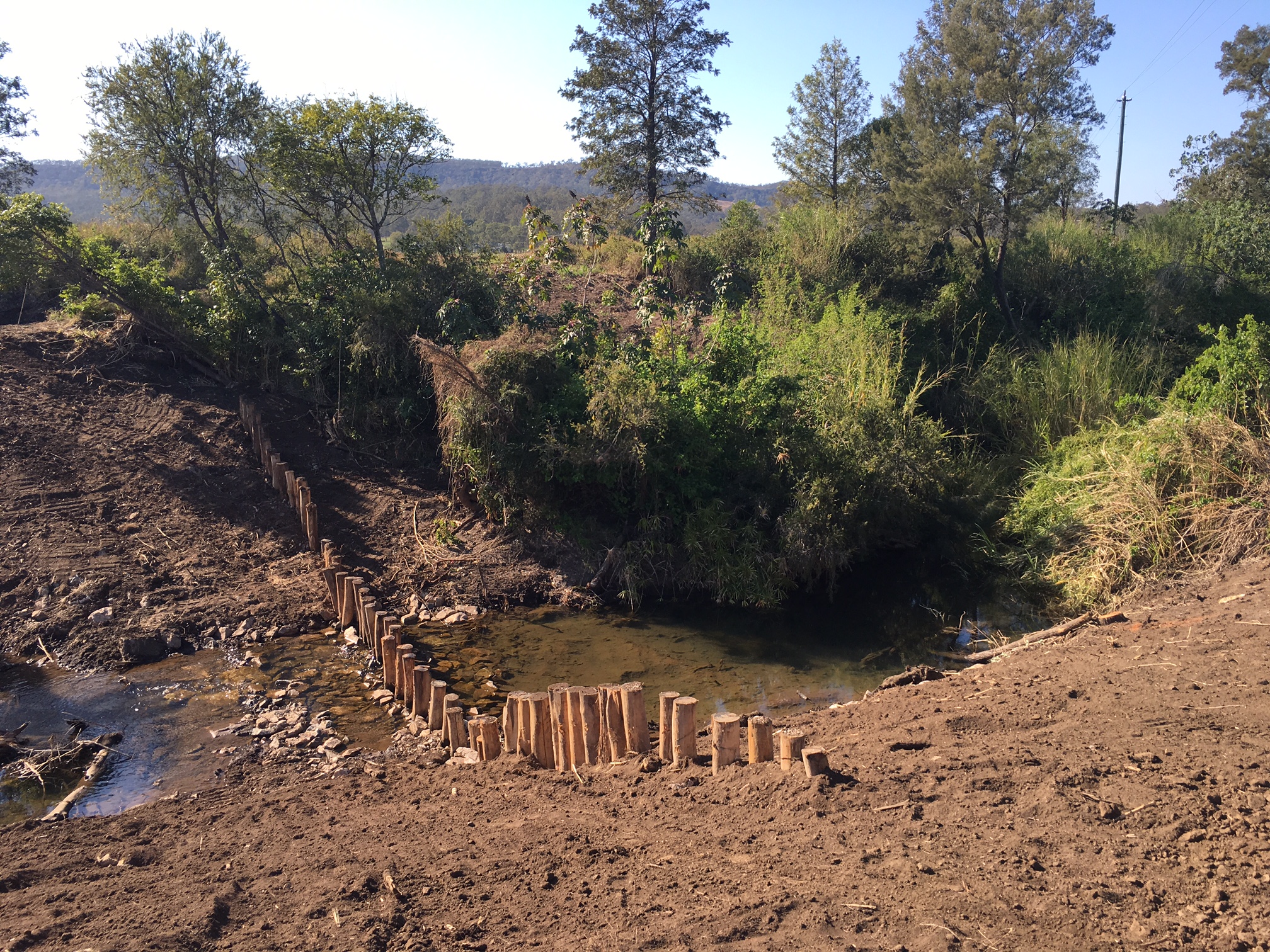

Laidley Creek
Our longest-running project is with Healthy Land & Water, where we have partnered to complete five stages of work at Laidley Creek under the Laidley Creek Restoration Master Plan. Across these five stages:
-
3.8km creek banks rehabilitated
-
Almost 20,000 tonnes of sediment prevented from entering the local waterway every year
-
11,104 native trees and 8,830 native plants planted
-
Reduced erosion risk for prime agricultural land, particularly during severe weather events.
DEVELOPMENT AT THE PORT
Developers at the Port need to comply with the Port of Brisbane Technical Guidelines to manage and treat stormwater.
Qualifying developers can partially meet stormwater quality requirements by investing into PBPL’s offsite stormwater treatment program. Contact PBPL for more details.
PBPL tracks development at the Port that is utilising offsite investment. The below table summarises the investments made in catchment management and the area of port development ‘treated offsite’.
Table 1: This table summarises investment made by the Port of Brisbane into catchment rehabilitation projects under its offsite stormwater treatment program and the amount of land at the Port that has utilised the investment.
|
Year
|
Offsite Investment
|
Hectares generated
|
Hectares used
|
Cumulative Hectares remaining
|
|---|---|---|---|---|
|
2015/16
|
$500,000
|
20.00
|
17.80
|
2.20
|
|
2016/17
|
$503,635
|
20.15
|
6.87
|
15.48
|
|
2017/18
|
$0
|
0.00
|
5.48
|
10.00
|
|
2018/19
|
$84,000
|
3.36
|
17.57
|
-4.21
|
|
2019/20
|
$242,000
|
8.96
|
6.42
|
-1.67
|
|
2020/21
|
$839,000
|
31.07
|
16.49
|
12.91
|
|
2021/22
|
$579,000
|
19.63
|
10.58
|
21.96
|
|
2022/23
|
$421,925
|
15.63
|
36.63
|
0.96
|
|
2023/24
|
$1,187,600
|
43.96
|
31.21
|
13.71
|
|
2024/25
|
$2,040,245
|
61.83
|
19.82
|
55.72
|
